Construction Sequencing
The 91st Ave AWPF construction sequencing will span around 32 months and consist of 8 construction phases. The table below shows CJE's proposed construction sequencing.

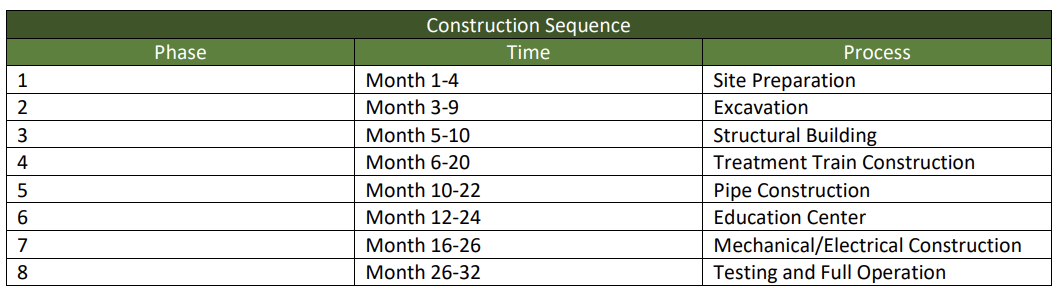

Table 1: 91st Ave AWPF Construction Phasing
